7 Factors to Evaluate Connected Worker Software

Connected worker software dashboard

Table of contents

Choosing connected worker software takes more than scrolling through feature lists. Every platform in this category will show you a clean mobile form and a dashboard, and none of that tells you whether your night shift will still be using it in month six.

This guide covers the seven factors that separate platforms once they are on the floor, a weighted scorecard you can copy, and 15 questions worth asking on a demo.

Key takeaways

  • Floor adoption determines return more than any single feature, because a platform operators avoid produces no data to act on.
  • The clearest line between a platform and a forms app is what happens after someone hits submit. A failed step should create an owned corrective action automatically.
  • Audit-ready records are attributable, system-timestamped, evidenced at the step, versioned, and retrievable. Ask to see all five.
  • Per-seat licensing puts a price on participation, in a program whose value depends on participation.
  • Test on your own floor, on your own network, and in your own cold room before you sign anything.

What should you evaluate before buying connected worker software?

Seven things, roughly in the order they determine success or failure:

  1. Whether the floor will actually use it
  2. Whether findings get tracked to closure
  3. Whether the records hold up in an audit
  4. Whether the pricing model lets everyone participate
  5. Whether it runs more than one program
  6. Whether it fits the systems you already run
  7. How fast it goes live and what support looks like afterward

Only two of those are feature questions, and the ordering comes from what goes wrong in practice. In Weever's 2026 State of Data Capture in Manufacturing research, 167 manufacturing leaders at companies with more than 500 employees were asked to name the single biggest factor hurting frontline data quality. Manual and paper-based processes came first at 36%, ahead of disconnected systems at 26% and lack of standardized processes at 19%. Inconsistent software adoption came last among operational causes at 10%.

Our reading of those results: most plants lose frontline data because the capture never happens, or never leaves paper. Picking the wrong features is a smaller cause.

1. Factory floor adoption and usability

Operators route around software that slows them down, and once they do, the platform's capabilities stop mattering.

Test it under real conditions, not in a conference room. Can a new hire complete their first task without a supervisor standing next to them? Does it work with gloves on? Can someone reach the right form by scanning a tag at the machine, or do they have to navigate a menu and log in first? These are the day-to-day realities for frontline operators, and they decide whether a rollout sticks.

The benchmark is that the digital version has to be faster than the clipboard. If it takes longer, the clipboard wins, usually quietly over about eight weeks rather than in a confrontation.

Ask about form length too. A sixty-field form tends to become a twelve-field form in practice, with the other forty-eight filled in from memory at the end of the shift.

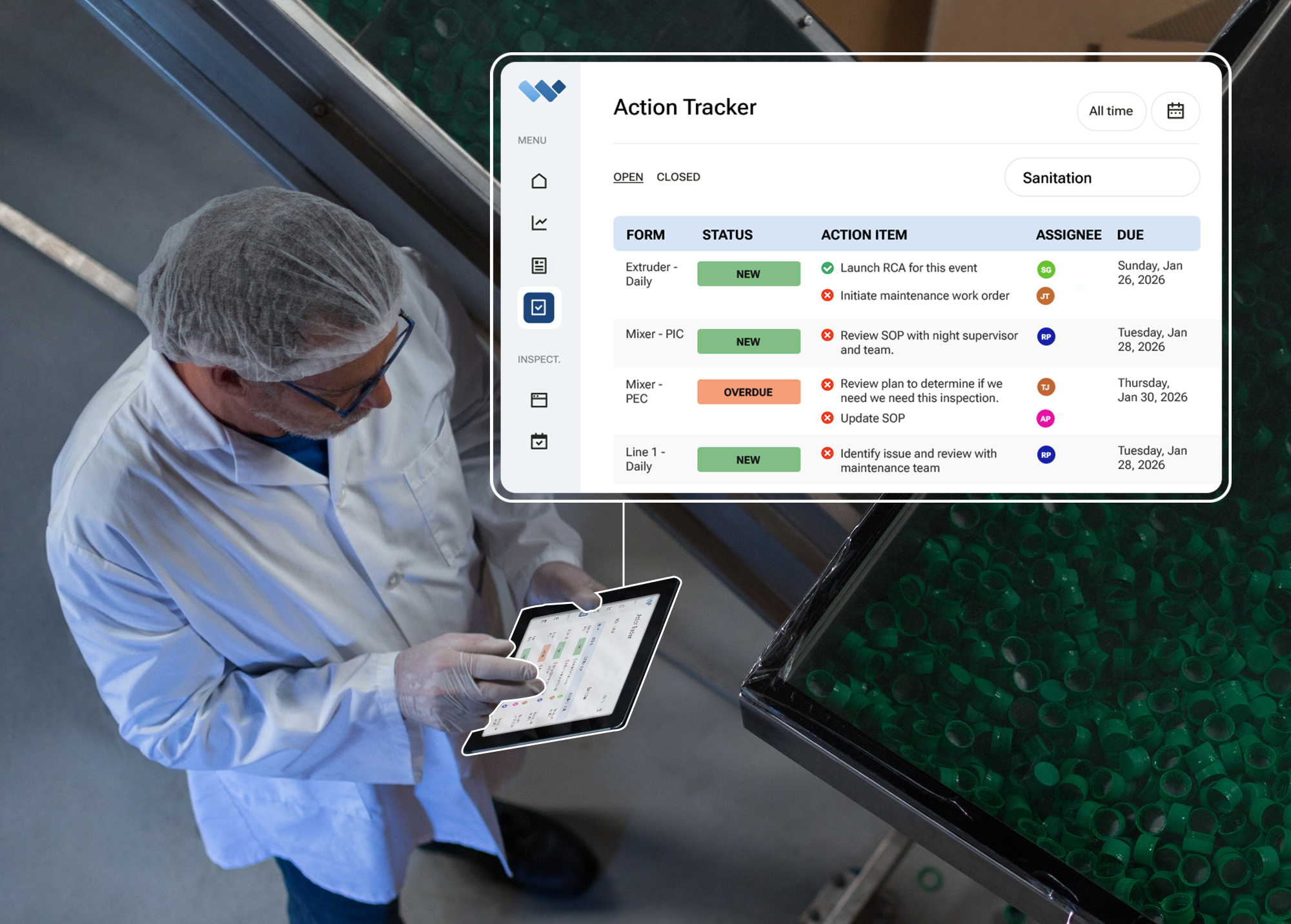

2. Corrective action tracking and closure

This factor separates a platform from a forms app, and buyers skip past it more often than any other.

Capturing data is half the job. What matters is what happens when a check reveals a problem. A failed step should create an action automatically, with an owner, a due date, and an escalation path, before the operator has walked to the next station. Nobody should have to read a submission, decide it matters, and assign it by hand.

Make corrective action closure rate your primary metric. Completion rate only tells you the check happened. Closure rate tells you whether anything the check found got fixed.

Mars Fort Smith reached 100% task completion within a month of go-live and an 89% corrective action closure rate. Royal Canin runs a 95% close rate.

There is a second reason closure matters, and it has more to do with people than paperwork. Operators decide whether to keep reporting based on what happens after they report. When they see problems get fixed, reporting becomes routine. When nothing happens, reporting tends to stop within a quarter, and the drop shows up in your data looking like improvement.

3. Compliance and audit readiness

Food manufacturing faces scrutiny from FSMA, HACCP, GFSI schemes, and customer audits. Whether the record in question is a sanitation task or a quality check, the underlying question is the same: can you prove this procedure was followed on this date by this person?

Five attributes make a record audit-ready. Ask to see each one:

Attribute What it means
Attributable Tied to a specific user, not to a shared device.
Timestamped By the system, not typed in by the person completing it.
Evidenced Photos attached to the individual step, not to the submission as a whole.
Versioned You can prove which revision of the procedure was in force on a given date.
Retrievable Twelve months of records for one line, in minutes.

If you operate under 21 CFR Part 11, ask the vendor exactly what they mean by "Part 11 ready." Vendors use the phrase to cover a wide range of actual capability.

4. Site-based pricing with unlimited users

Per-seat licensing creates a problem that does not show up until the program starts working.

When each additional user costs money, plants limit who gets an account. The limit usually lands on the people furthest from the office, who are also the people doing the observing. The result is a connected worker program in which most of the workers are not connected.

Per-seat pricing also penalizes success. A rollout that goes well brings more people in, so the invoice grows at exactly the point you are trying to expand.

‍Site-based pricing with unlimited users removes that decision. Everyone can report, so problems surface earlier and more of them get found.

Whatever model you evaluate, price out five programs across all your sites, not just the pilot. The two numbers diverge sharply. For the return side of the comparison, ROI calculators for sanitation, autonomous maintenance, and 5S audits can help you frame the business case.

5. Support for multiple programs on one platform

Plants run overlapping frontline programs: sanitation, autonomous maintenance, quality checks, safety observations, 5S audits, and work instructions. Running each in a separate tool creates silos and duplicate administration for the same supervisors.

It also breaks something less obvious. When each program has its own tool with its own fields, the same failure gets described four different ways depending on which program caught it. An issue logged on a quality check cannot be compared with the same issue logged on a safety observation, because the two were never recorded as the same thing.

In the Weever research, 51% of leaders said the same issue is frequently or very frequently recorded differently depending on who logs it. Separate tools for each program make that worse by design.

Ask whether additional programs require new modules, new contracts, or new fees, and whether they share one set of field conventions and one corrective action workflow.

6. Integration with existing systems

Your plant already runs an ERP, probably a CMMS, and some form of BI. A connected worker platform should fit into that stack rather than replace it.

For most plants, the CMMS integration matters most. When an operator finds an abnormality that needs a technician, a part, and a scheduled window, it should escalate into the maintenance system as a work order with the photo and context attached. A supervisor should not have to retype it.

BI comes next. Frontline completion and closure data should land in the reports leadership already reads, without someone rebuilding a deck by hand every Monday.

AI raises the stakes. In the same Weever research, 81% of leaders agreed that disconnected systems limit the effectiveness of AI across their operations.

Ask for specifics: which systems, through what mechanism, and whether you can see a live example.

7. Implementation speed and ongoing support

Ask two questions: how long it takes to go live on one program on one line, and how much of your IT team's time that requires.

Good answers are measured in weeks and in single-digit IT days. IT involvement should be limited to single sign-on, device policy, and integrations. If a vendor needs sustained IT development to configure a checklist, that checklist will drift out of date within a year, because nobody will raise a ticket to change a form.

Ask who does the configuration work during rollout, and who does it in year two when your process changes. A plant admin should be able to edit a form without contacting support. As a reference point, here is how Weever handles onboarding and implementation.

Monin rolled out across its North American operation in five months.

Connected worker software evaluation scorecard

Copy this into a spreadsheet and score each vendor from 1 to 5. The weightings reflect what predicts success on the floor, which is often different from what is easiest to demo.

Factor Weight What a 5 looks like
Floor adoption and usability 25% Faster than the clipboard, QR entry, works with gloves, no per-task login, tested on your floor
Corrective action closure 20% Automatic action creation on failure, owner and due date, escalation, closure with evidence
Audit readiness 15% All five attributes: attributable, system-timestamped, evidenced at step, versioned, retrievable in minutes
Pricing model 15% Site-based with unlimited users, all programs included, no per-seat ceiling on participation
Multi-program support 10% All frontline programs on one configuration with shared field conventions
Integration 10% Proven CMMS and BI connections, API, portable data export
Implementation and support 5% Weeks per program, minimal IT, plant admin can edit forms unaided

One caution on scoring. Adoption and closure carry 45% between them because they determine whether anything else matters, and they are also the two hardest to assess from a demo. Weight your evidence accordingly: insist on a floor trial for adoption, and a live walkthrough of a failed check for closure.

15 questions to ask on a connected worker software demo

Questions to ask on a connected worker software demo

15 questions · 5 areas

On adoption

  1. 1Show me an operator completing a check from scan to submit, timed.
  2. 2Can we test this on our own network, including the areas where coverage is weakest?
  3. 3How does a shared tablet attribute a task to the right person without a full login each time?
  4. 4Can an operator complete this in Spanish if the form was built in English?

On the closed loop

  1. 5Fail a step in front of me. Show me what gets created and who sees it.
    Most diagnostic question
  2. 6What happens when that action passes its due date?
  3. 7Show me your closure rate report and how aging is displayed.

On audit and compliance

  1. 8Pull twelve months of records for one asset while I watch.
  2. 9Prove which version of this procedure was in force six months ago.
  3. 10Can anyone edit a timestamp, including an admin?

On commercials and scale

  1. 11Quote me for five programs across all my sites, with every employee having access.
  2. 12What is not included in that number?
  3. 13What does adding a second site cost, and how long does it take?

On implementation

  1. 14How many days of my IT team's time, specifically?
  2. 15Who edits a form in year two when my process changes, and how long does it take?

Question 5 is the most diagnostic on the list. With a forms app, you will see a submission land in a table. A platform should show you an owned action with a due date and an escalation path.

Choosing software your floor will actually use

The right platform fits the process you already run instead of forcing your teams to redesign how they work. It gives you records that hold up in an audit, it drives findings to closure instead of just documenting them, and it does not charge more for the participation that makes it work.

Weever is built for food, beverage, and CPG manufacturers running sanitation, autonomous maintenance, quality checks, safety, and 5S. It offers site-based pricing with unlimited users, is configured to your process, and goes live in weeks.

Want to run this scorecard against your own requirements? Book a demo.

‍

Frequently Asked Questions

What should you look for in connected worker software?

Floor adoption, corrective action closure, audit-ready records, a pricing model that does not limit participation, multi-program support, integration with your CMMS and BI tools, and fast implementation with minimal IT involvement. Adoption and closure matter most because they determine whether anything else has value.

How is site-based pricing different from per-seat licensing?

Site-based pricing charges one fee per facility, however many people use it. Per-seat pricing charges for each user, which limits who gets access and makes costs grow as the program succeeds. In a category whose value depends on participation, that is a structural constraint as well as a line item.

What compliance standards should a connected worker platform support?

For food manufacturing, expect FSMA, HACCP, GMP, and the relevant GFSI scheme, plus 21 CFR Part 11 for electronic records where applicable. Look for audit trails, version control, signature attribution, system-generated timestamps, and fast retrieval.

How long does implementation take?

One program on one line should go live in weeks. Full multi-program, multi-site rollouts take longer and should be sequenced rather than launched all at once. Timelines stretch most when a plant tries to redesign its processes while digitizing them.

What metric should I track to know if it is working?

Corrective action closure rate, and time to closure. Completion rate only proves the check happened. Also watch reported issue volume, which should rise after go-live. A rise means people trust the system enough to report.

Can connected worker platforms integrate with ERP and CMMS?

Most can, through APIs, scheduled exports, or direct connections. For most plants, the highest-value integration escalates an operator-reported abnormality into the CMMS as a work order with the photo and context attached, so nobody has to retype it.

Should I run a pilot before committing?

Yes. Run one program on one line, on your own floor, in real conditions, including cold rooms, washdown areas, and the spots where network coverage is weakest. A conference room demo tells you nothing about how the platform performs on your network, whether it works with gloves, or whether the digital version is faster than the clipboard.

‍

Spend Less Time on Admin. More Time Improving Operations.

See how Weever automates data entry, reporting, and action items so you can focus on improvement not admin.

Notification showing John Koldus updated status to Complete in defect number 6723, 1 minute ago.85 percent completion rate displayed on a dark rounded square background.
